Deering Avenue Sewer Extension Project

Project Goal:

  • Replaced the failing shared sewer lateral serving 283, 287, 291, and 293 Deering Ave.

Project Scope:

  • Installed approximately 220 LF of 8” diameter sewer main and two sewer manholes in the location of the existing shared sewer lateral.
  • Replaced the 283, 287, 291, and 293 sewer laterals up to the property line.
  • Reconstructed the sidewalk and driveway aprons from 113 Fessenden St to 293 Deering Ave.
  • Replaced the fire hydrant in front of 293 Deering Ave and replaced the water services for 283, 287, 291, and 293 Deering Ave up to the property line.
  • Removed two trees from the right of way and installed four new trees.

Traffic Impacts:

  • The City’s contractor, D&C Construction, began working in the Deering Ave right-of-way from Pitt St to Fessenden St on Wednesday April 30, 2025. They demobilized from the site on Tuesday July 22, 2025.
  • Pedestrian and traffic impacts included sidewalk closures on one side of the street and alternating one-way traffic during work hours.
  • D&C Construction closed Pitt St to local traffic only between Deering Ave and Oakdale St to conduct work in the Pitt St right of way.

Construction Hours:

  • Monday - Friday, 7:00am - 7:00pm

Project Contact:

Reed Allen, P.E.
Water Resources Project Engineer
Email: rhallen@portlandmaine.gov
Phone: (207) 874-8828

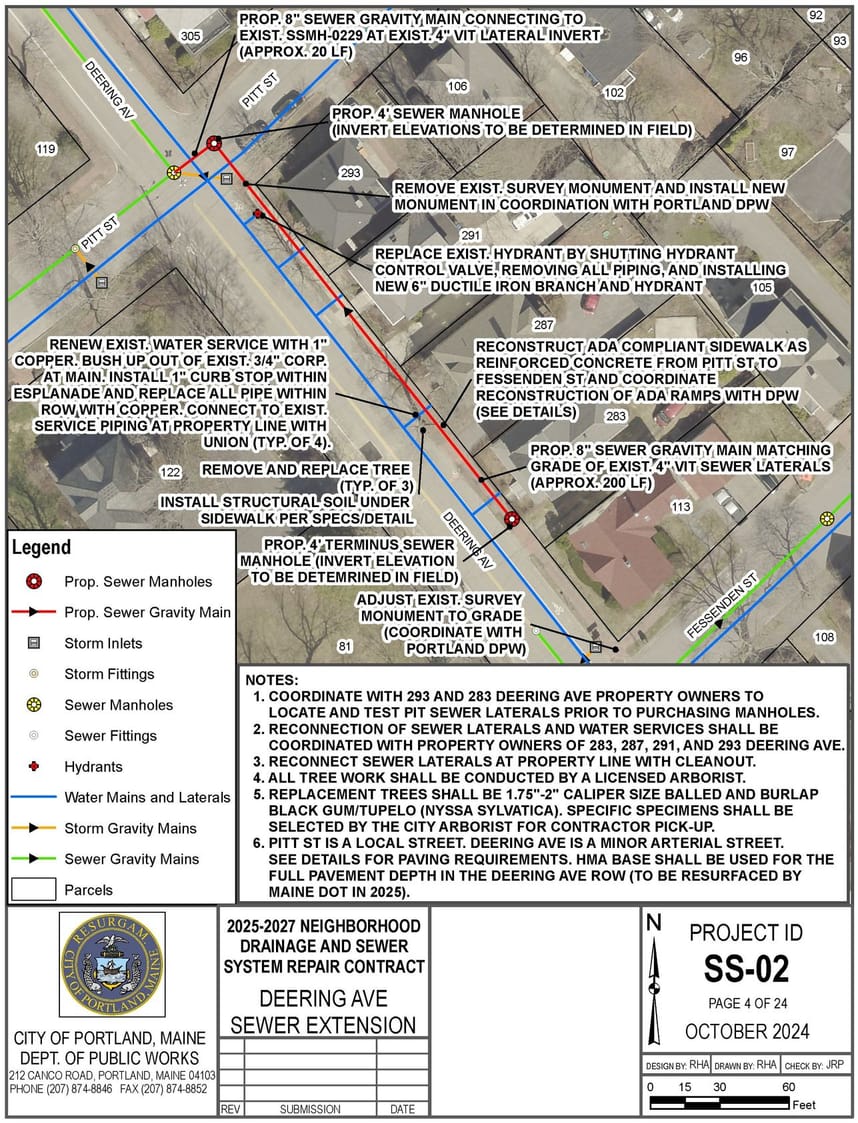

Project Plan

Stay Informed

Get notified on upcoming engagements and the latest project related news.

Project Phases

Construction

April 2025 - July 2025

Contractual Correction Period

July 2025 - July 2026

Project Closeout

July 2026 - December 2026
