Denton, TX

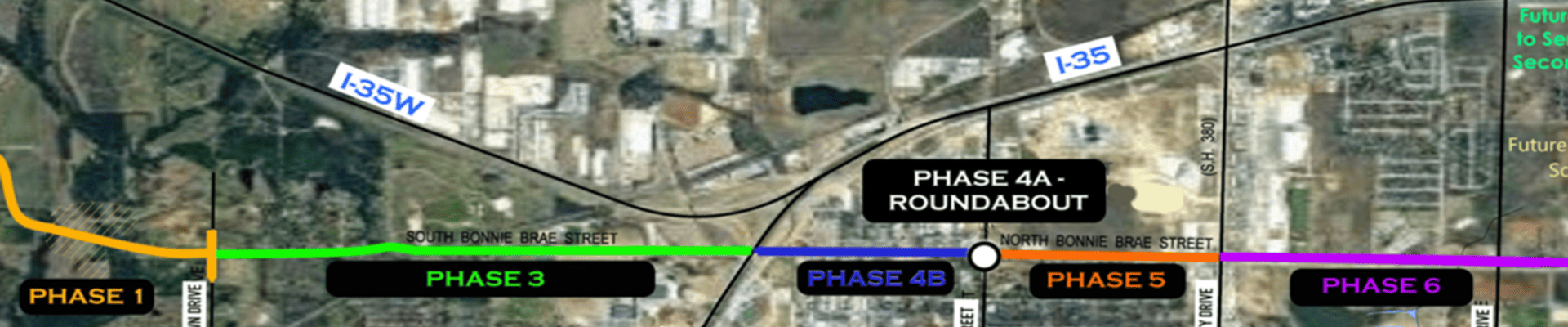

Map of phase plan for Bonnie Brae Street

Bonnie Brae

To accommodate mobility needs, Bonnie Brae Street is being expanded from a two-lane undivided rural roadway to a four-lane divided urban street section. This six-phase project has three phases completed (1,2 & 4A), Phases 3 and 6 are currently in construction. Below are the project limits and status for each phase.

PROJECT PHASES & STATUS

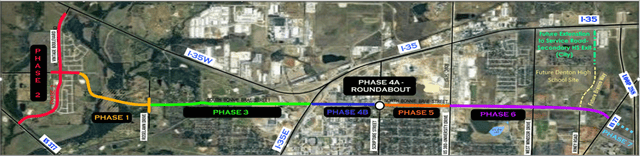

Project Limits: Bonnie Brae Street from Vintage Blvd on the south end to US77/Elm Street on the North end. Once Complete, Bonnie Brae will be a 6 mile, north-south, 4 lane divided, urban connector with quick access to Loop 288, US380, I-35E, FM1515, I-35W and US377.

Phase 1 (Roselawn to North of Vintage Boulevard) - COMPLETE

Phase 2 (I-35W TO US 377 Includes Vintage Blvd) - COMPLETE

Phase 3 (Roselawn to IH-35E) IN CONSTRUCTION
Project Timeline: 2023 - 2026

Robin Davis, Project Manager - robin.davis@cityofdenton.com

Sundt Construction was issued a Notice to Proceed on October 16, 2023. The project is expected to be complete in November 2026 (weather permitting).

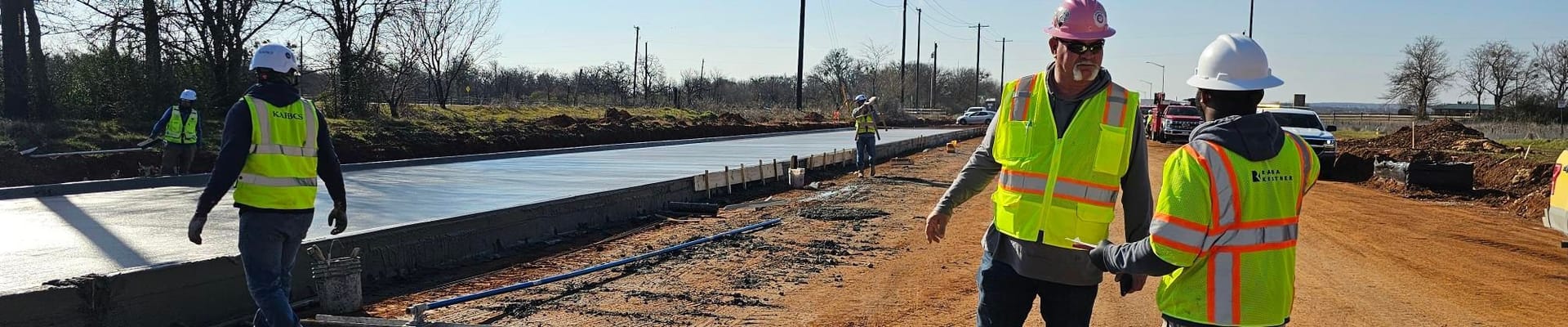

New concrete lanes are open to north and south bound traffic, one-lane each, from I-35E Service Road and Roselawn Drive. The traffic signal at the intersection of Airport Road/FM 1515 and Bonnie Brae is expected to be activated by mid February.

Any full or partial lane closures lasting longer than 2 days will be updated on the city street closure report: https://lfpubweb.cityofdenton.com/publicweblink/browse.aspx?dbid=4&startid=44284&cr=1
Message Boards will be updated with any closures and detours will be posted accordingly.

Phase 4A (Roundabout at Scripture) - COMPLETE

Phase 4B (I-35E Service Road to Roundabout at Scripture)
Project Timeline: TBD

Robin Davis, Project Manager - robin.davis@cityofdenton.com

In 2024, this section of roadway had a 2-inch overlay as part of the North South Water Phase 3, 42-inch Water Transmission Main project. Phase 4B of the Project will provide full depth repair to all 4 lanes and add a raised median matching Bonnie Brae Phases 3 and 6. Updated street lighting and sidewalk will also be installed in gap areas. City Streets Department continues to perform maintenance and pothole repair as needed.

Phase 5 (Roundabout at Scripture to US380)
Project Timeline: TBD

Sheldon Gatewood, Project Manager - sheldon.gatewood@cityofdenton.com

Phase 5 of the Bonnie Brae Roadway Project will provide full depth repair to all 4 lanes and add a raised median matching the Bonnie Brae corridor and connecting the US380-University Drive Intersection. Sidewalk and updated street lighting will also be installed.

Phase 6 (US380 to US77) IN CONSTRUCTION
Project Construction Timeline: 2025 - 2027

Jesus Perez, Project Manager - jesus.perez@cityofdenton.com

Tiseo continues work on the underground utilities and drainage facilities. They have also began the grading work for what will be the future lanes of the new 4-lane divided street. Sidewalk and street lighting will also be added.

NOTE:

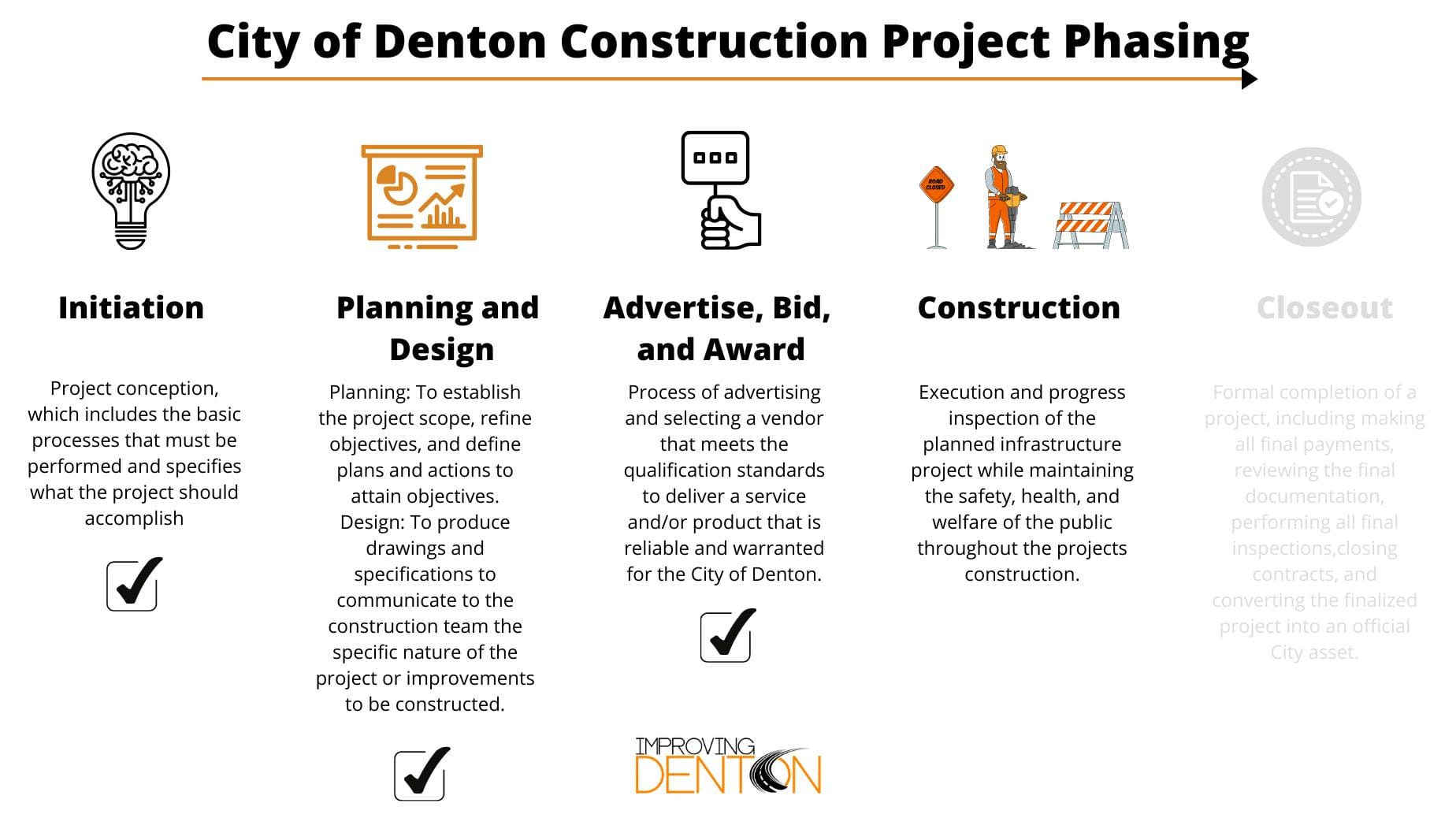

Project phases are listed for active and/or planned projects. These phases reflect the range of a project life cycle from project initiation to project completion & close-out.

The year range reflected is for the estimated construction timeline only. These estimated construction timelines may change due to weather, contractor scheduling, material delays, and/or other factors. Timelines will be updated when needed.

All Bonnie Brae Phases are shown, including COMPLETED Phases in an effort to show the entire Bonnie Brae Corridor.

Estimated Budget: $140 million

Funding Sources:
2012, 2014, and 2019 Bond Programs
TRIP08 & TRIP22 County Bond Programs
NCTCOG RTR Funds

Sponsoring Departments & Partners:
Capital Projects
Streets Department
Water & Wastewater Utilities
Denton County
North Central Texas Council of Governments

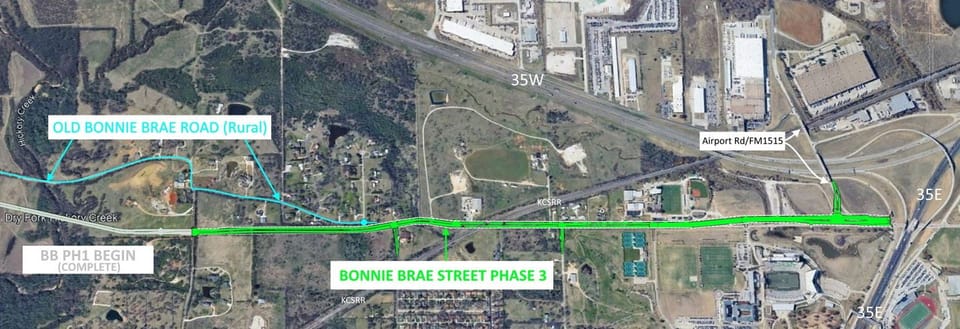

Map of Bonnie Brae Street Phase 3

Stay Informed

Get notified on upcoming engagements and the latest project related news.

Robin Davis, Jesus Perez, Sheldon Gatewood
Construction Projects Managers CIP.Admin@cityofdenton.com

Project Updates

35 items

Phase 6 - Temporarily and intermittently closure of Conquest Drive for limeing operations

Limeing Operations across Conquest Drive to begin.

View Update

Bonnie Brae Phase 6 - Updated Road Closure Notice

Bonnie Brae Phase 6 - Updated Road Closure Notice

View Update

Phase 6 - Contractor to lower existing waterline for clearance of new infrastructure

Existing waterline lowering

View Update

Phase 6 - Road Closure Update - Bonnie Brae from US77 to Riney Road

Phase 6 - Road Closure Update - Bonnie Brae from US77 to Riney Road

View Update

Phase 6 - Construction activities continue between Conquest Drive and US77

The Contractor continues to make advancements to the roadway construction on the North side of the project.

View Update

PHASE 3 - (Airport Road/FM 1515 to Roselawn) *WILLOWWOOD CLOSED until November 1.

On Monday September 8th, the contractor closed Willowwood Street to begin subgrade work in preparation for concrete and asphalt paving.

View Update

Phase 6 - Construction Activities between University Drive to Windsor Drive

Tiseo Paving Company is making preparations to mobilize between W. University Drive (US380) to Windsor Drive.

View Update

PHASE 3 (FM1515/Airport Rd to Roselawn) 9.10.2025 Bonnie Brae CLOSED between Willowwood & Parvin

On Wednesday, September 10th, the contractor will close Bonnie Brae between Willowwood and Parvin to complete the drainage infrastructure, subgrade work and paving of the northbound lanes in this section.

View Update

Phase 6 - Reeves Elementary School access along Riney Road

Vehicular Traffic will have access to the new Reeves Elementary School by using Riney Road.

View Update

PHASE 3 (FM1515/Airport Rd to Roselawn) FULL ROAD CLOSURE: AIRPORT ROAD, BONNIE BRAE at 35E - 7.30 through 8.18.2025

On Wednesday July 23rd, TxDOT advised they would be closing South Bonnie Brae from Airport Road to I35E for their contractor (SEMA) to complete the state’s portion of Bonnie Brae and the Service Road.

View Update

PHASE 3 (Airport Rd/FM 1515 to Roselawn) PARVIN ROAD CLOSED 7.21 - 9.5.2025

Parvin Road between Larkhall Lane and Bonnie Brae will be closed on Monday July, 21st to install the drainage infrastructure crossing under Parvin and complete paving improvements of Parvin as it relates to Bonnie Brae Phase 3.

View Update

Phase 6 - Contractor continues to work on concrete pavement detour.

Contractor continues to work on concrete pavement detour at the intersection of Bonnie Brae and Riney Road.

View Update

Phase 6 - Contractor continues to install 16-inch ductile iron pipe along Bonnie Brae

The Contractor continues to install the 16-inch ductile iron pipe along Bonnie Brae from Riney Road to Windsor Drive.

View Update

Phase 6 - Installation of 12-inch waterline for Reeves Elementary School

Tiseo Paving Company is installing a 12-inch waterline where the Contractor building Reeves Elementary School will tie-in for their water supply.

View Update

PHASE 3 - FM1515/Airport Road to Roselawn

Phase 3 is progressing with installation of the new water and sanitary sewer systems as well as new underground drainage infrastructure at both the north and south ends of the project.

View Update

Phase 6 - Full Notice to Proceed given to Tiseo Paving Company

On March 10, 2025, the City of Denton issued a full Notice to Proceed to Tiseo Paving Company to be able to fully mobilize into the project limits.

View Update

Partial Notice to Proceed issued to Tiseo Paving Company

City Staff issued a Partial Notice to Proceed (NTP) to Tiseo Paving Company on February 10, 2025.

View Update

Construction Award to Tiseo Paving Company (Bonnie Brae Phase 6 - University Dr. to N. Elm St.)

On December 17, 2024, the City Council award a contract to Tiseo Paving Company for the construction of the Bonnie Brae Phase 6 Improvement Project.

View Update

News Feed - January (Bonnie Brae Phase 5_ University - Scripture)

City Council has voted this project to be reclassified to a Mill/Overlay project and for the funds to be disruptive to other Capital Projects.

View Update

News Feed - December (Bonnie Brae Phase 5_ University - Scripture)

The City of Denton Internal Engineering team has completed the 30% design phase of the project.

View Update

News Feed - November (Bonnie Brae Phase 5_ University - Scripture)

The project design is currently in progress, with the 30% design phase scheduled for internal review by the end of this month.

View Update

Texas Department of Transportation reviews Bid Opening Documentation! (Phase 6)

The Texas Department of Transportation is currently reviewing the bid opening documentation submitted by the lowest apparent bidder.

View Update

News Feed - October (Bonnie Brae Phase 5_ University - Scripture)

Internal design work is ongoing, with the road alignment already determined.

View Update

Bid Results being analyzed for approval by Stakeholders (Phase 6)

The Bid Opening Meeting was held on August 28, 2024.

View Update

News Feed - September (Bonnie Brae Phase 5_ University - Scripture)

Internal design work is currently underway, with the road alignment already determined.

View Update

The Pre-Bid Meeting is scheduled for August 8th! (Bonnie Brae Phase 6)

The Bidding Phase continues for the project. The Pre-Bid Meeting is scheduled to occur on August 8th.

View Update

News Feed - August (Bonnie Brae Phase 5 _University - Scripture)

Internal Engineering working on an internal design project with a key milestone of a 30% design review projected for the first week of September.

View Update

The Bidding Phase has arrived! (Bonnie Brae Phase 6)

After a successful meeting with the Solicitation Review Committee, the Bonnie Brae Phase 6 Improvement Project will advertise for bidding starting on July 19, 2023.

View Update

News Feed - July (Bonnie Brae Phase 5 _University - Scripture)

With the completion of topographic and boundary surveys as a crucial step in this project phase now complete. Internal Design is currently underway.

View Update

Waiting on Texas Department of Transportation Letter of Approval! (Bonnie Brae Phase 6)

The Texas Department of Transportation (TxDoT) is completing their final review of the construction plans and project manual.

View Update

News Feed - June (Bonnie Brae Phase 5 _University - Scripture)

With the completion of topographic and boundary surveys as a crucial step in this project phase now complete.

View Update

Contract Documents being finalized! (Bonnie Brae Phase 6)

In addition to completing the construction plan set, completing the Contract Documents are equally important.

View Update

Revisions to the 100% Plan Set continues at TxDoT

The City's Consultant Engineer continues to make revisions as TxDoT progresses with their review.

View Update

100 Percent Plans submitted to TxDoT

The Consultant Engineer in charge of designing the Bonnie Brae Phase 6 plan set has submitted to Texas Department of Transportation for final review.

View Update

Bonnie Brae Phase 6 (US 380/University to US 77/Elm Street)

Bonnie Brae Phase 6 is on track to advertise for bid in Q4 2023 pending the completion of the remaining utility relocation agreements.

View Update
