Pecan Creek 4 - Phase 3 & 4
Overview:
Pecan Creek-4 Phases 3 and 4 Drainage Improvements project which includes:
- 2,700 linear feet of reinforced concrete box
- 2,300 linear feet of waterline relocation and lowering
- 1,700 linear feet of sanitary sewer line relocation and adjustment
- pavement repair from West Prairie Street to the beginning of the open channel near the intersection of West Mulberry Street and Bernard Street;
Project Overview:

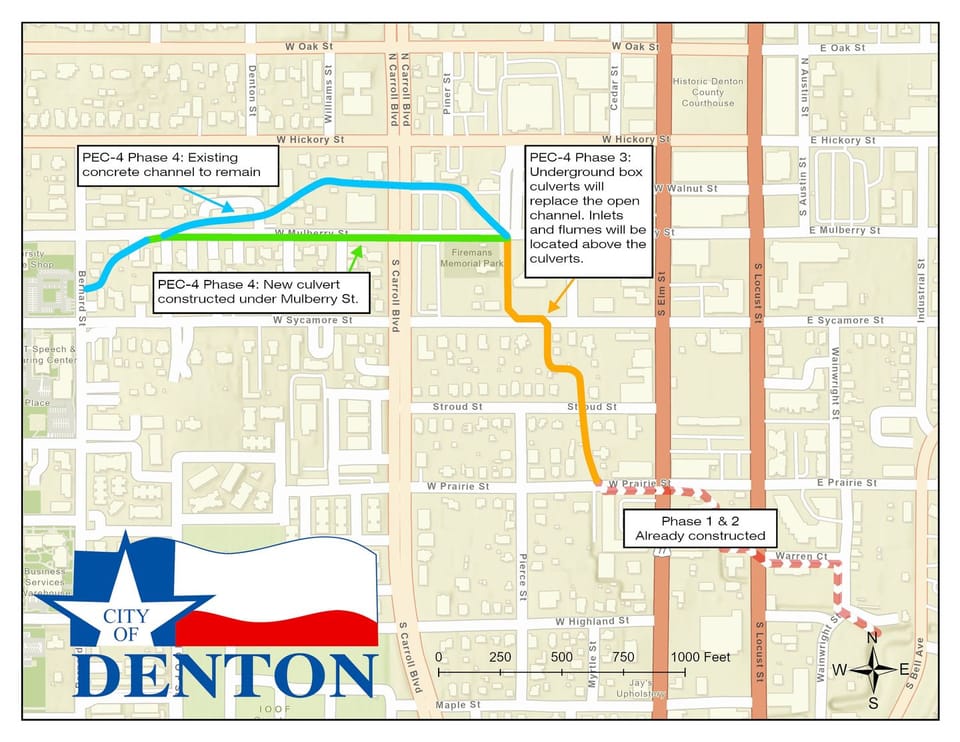

The PEC 4 Drainage Improvement project is a multi-phase project listed in the City’s Capital Improvement Program with the purpose of flood prevention within a portion of the Pecan Creek Tributary #4. The limits of the project extend along Pecan Creek Tributary 4 from the improved channel at Wainwright Street and Bell Avenue, northwest to Mulberry Street, just east of Bernard (Exhibit 2- Location Map). The general improvements for this project are the installation of an underground storm sewer capable of containing a 100 year flood event.
Stay Informed
Get notified on upcoming engagements and the latest project related news.

Project Updates
News Feed - March
City currently acquire necessary easements needed. City staff met with Private development on waterline installation on Mulberry. City staff is working with Residents on negotiations.
News Feed - February
Update for February 2026
News Feed - September
IOL Packets being issued to all easements under acquisition.
News Feed - April
We are actively progressing towards finalizing our project design, with our current completion at 95%.
News Feed - March
City Staff were authorized by the City Council to proceed with seeking eminent domain to purchase property required for the project.
News Feed - February
We are pleased to report that the 95% plan set have successfully undergone the Quality Assurance/Quality Control (QA/QC) process.
News Feed - January
The surveys and title work for all essential easements required for the project have been completed.
News Feed - December
The City of Denton Internal Real Estate department is currently finalizing the necessary paperwork to submit to the City Council for approval of key land acquisitions needed for the project.
News Feed - November
Pinnacle and the City of Denton Internal Real Estate are currently finalizing all required documentation to present to the City Council for approval of key land acquisitions necessary for the project.
News Feed - October
Pinnacle has distributed introductory letters to all properties affected by the project.
News Feed - September
The topographic survey and Subsurface Utility Engineering (SUE) activities have been successfully completed, providing a solid foundation for the next phases of the project.
News Feed - August
The project is progressing well, with the topographic survey nearing completion and Subsurface Utility Engineering (SUE) activities continuing.
News Feed - July
The project is advancing well, with the design phase nearly complete at 95% to incorporate the additional scope.
News Feed - June
The project is advancing with multiple components actively being developed.
News Feed - May
The project has been approved by both the City Council and the Public Utility Board, and communication with Freese and Nichols has begun to get designs finished along with getting the Right-of-way acquisition process started
News Feed - April
The project's progression is well-aligned with the scheduled milestones, indicating a structured and timely approach.
News Feed - March
Contract to be submitted to City Council and Public Utility Board for review/Approval.
News Feed - February
90% Design Amendment Draft is currently under review. Right of Way acquisitions shall begin soon.
News Feed - January
The city of Denton Staff working on finishing the Design and is in the process of Easement acquisition.
